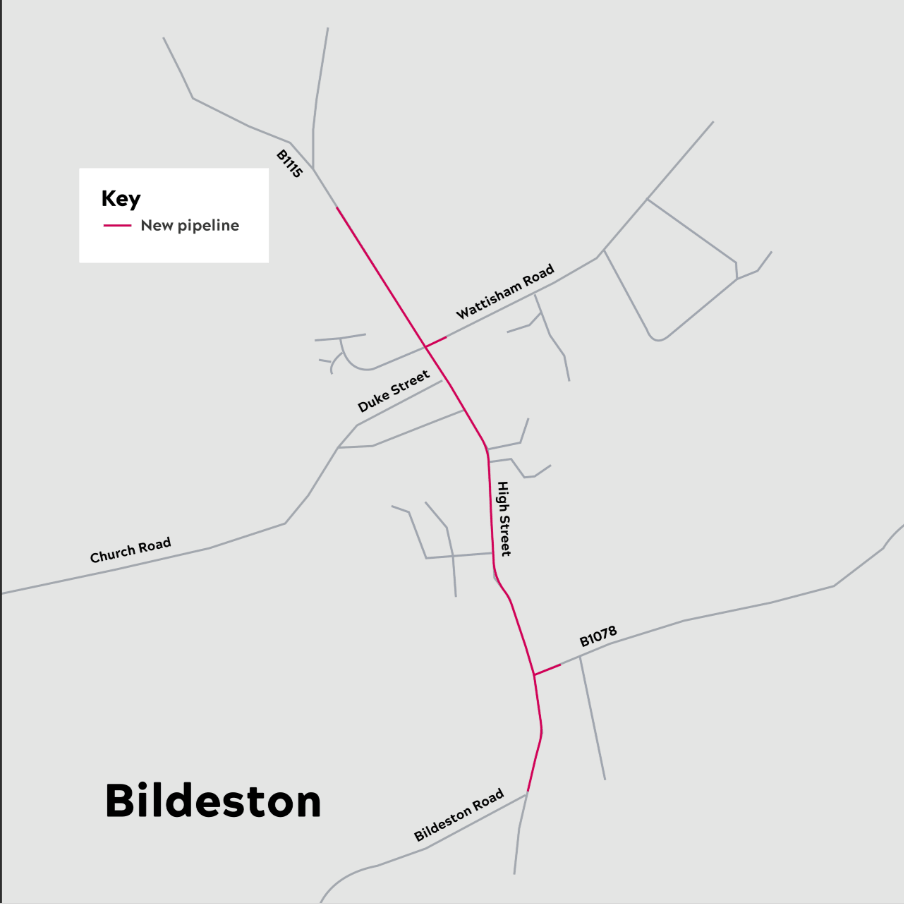

We're building for better in Bildeston, with over £1 million of investment to strengthen the water network, reducing bursts and interruptions for the community. We'll use this page to give updates on our progress once our work starts.
We’re installing a kilometre of brand-new water pipes along the High Street to help cut down bursts and keep taps flowing.
Come and see the team!
Before the work gets underway, we want to work closely with everyone living and working in Bildeston. If you have any questions about how the roadworks might affect you, or just want to understand what to expect, please come and have a chat with the team.
We’re holding a drop-in event at Chamberlin Hall on 14 April, between 2pm and 6:30pm, so you can speak to the team delivering the work and see all of our roadworks plans and maps.
When and where will the new pipes be installed?

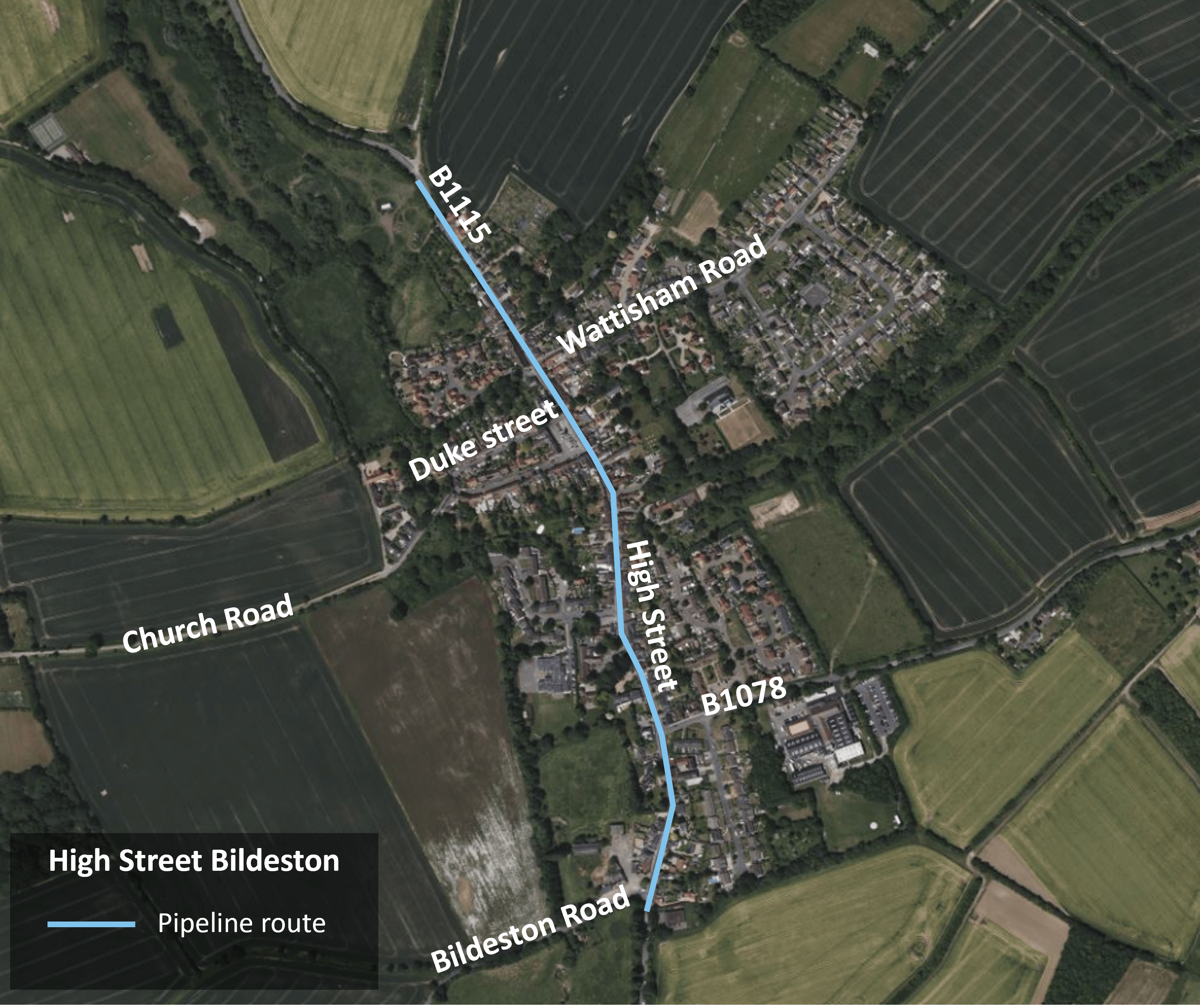

Our new pipes will be installed underground along High Street. The pipeline will start from the Ipswich Road junction and will carry on up the High Street until the end of the village. We’ll start installing the new pipes on 22 June, and if everything goes smoothly, we’ll be finished in November.
What roadworks will we need?
We know road closures are disruptive and that’s why they’re always a last resort for us. We’ll always look at other options first, working closely with the local authority to agree the safest way to carry out the work. Because of where the new pipe needs to go in the road, we will need to close High Street in sections, so we can keep road users, local residents and our teams safe while we get the job done.
When road closures are in place a signposted diversion route will be in place via Hitcham, Cross Green, Stowmarket and Needham Market.
This is our current plan for the roadworks, but the dates are very likely to change as the work progresses. We’ll keep this page updated so you always have the latest information.
| What | Where | Start | End |
|---|---|---|---|
Phase 1 road closure and traffic lights |
Ipswich Road and the High Street |
22 June |
26 June |
Phase 2 road closure |
High Street from the junction of Ipswich Road to the entrance to the health centre (entrance to remain open) |
29 June |
17 July |
Phase 3 road closure |
North of the entrance to the Health Centre to the junction of Newberry Road leaving access into Newberry Road |
20 July |
31 July |

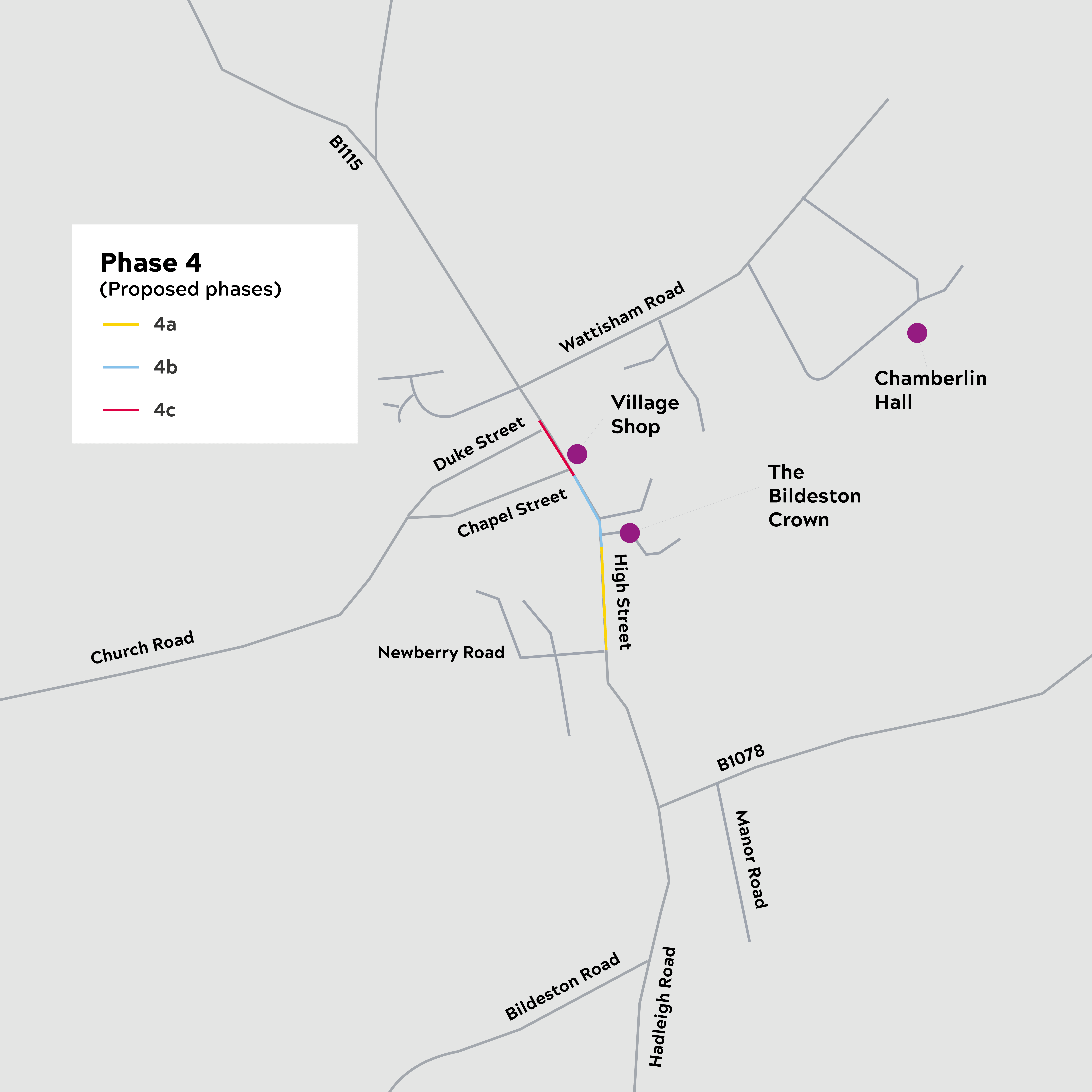

Phase 4a road closure |
North of the entrance to Newberry Road to the car park of The Crown |
3 August |
14 August |
Phase 4b road closure |
North side of The Crown car park to the junction of Chapel Street |
17 August |
28 August |
Phase 4c road closure |
Chapel Street to Duke Street |
31 August |
4 September |
Phase 5 road closure |
Duke Street to Wattisham Road |
7 September |
29 September |
Phase 6 road closure |

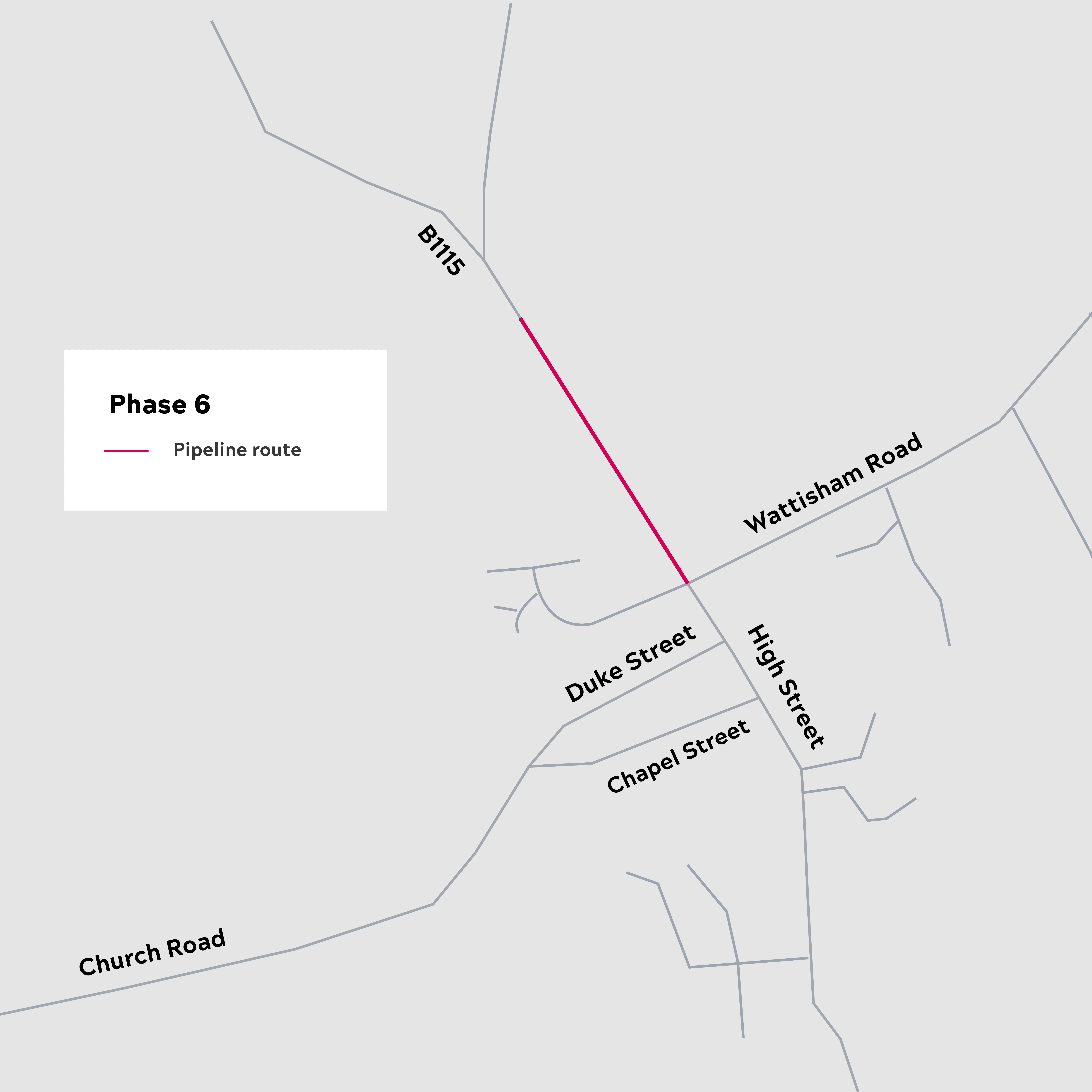

Wattisham Road to the end of the village |
30 September |
13 November |

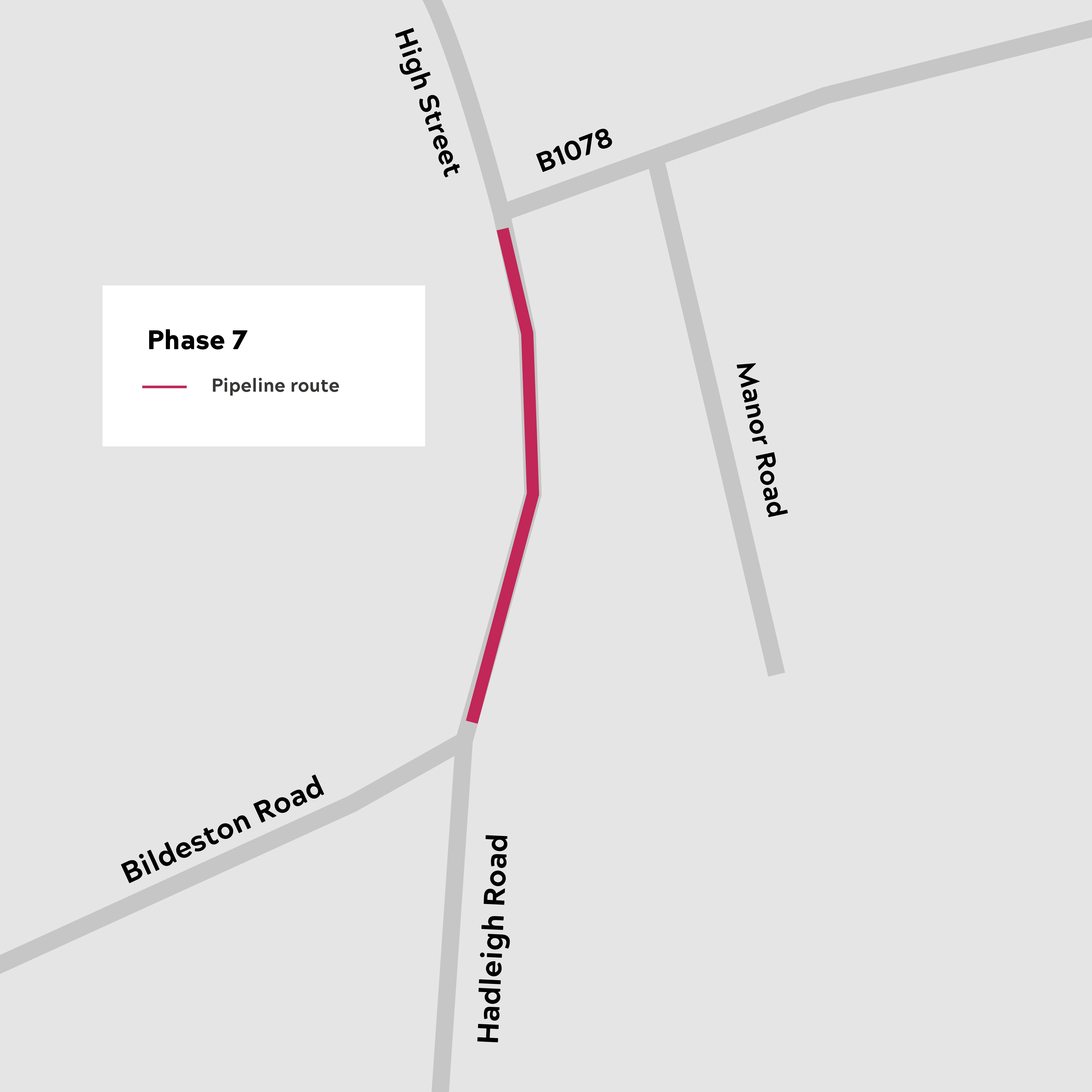

Phase 7 |
Bildeston Road to Ipswich Road |
TBC early 2027 |
TBC early 2027 |

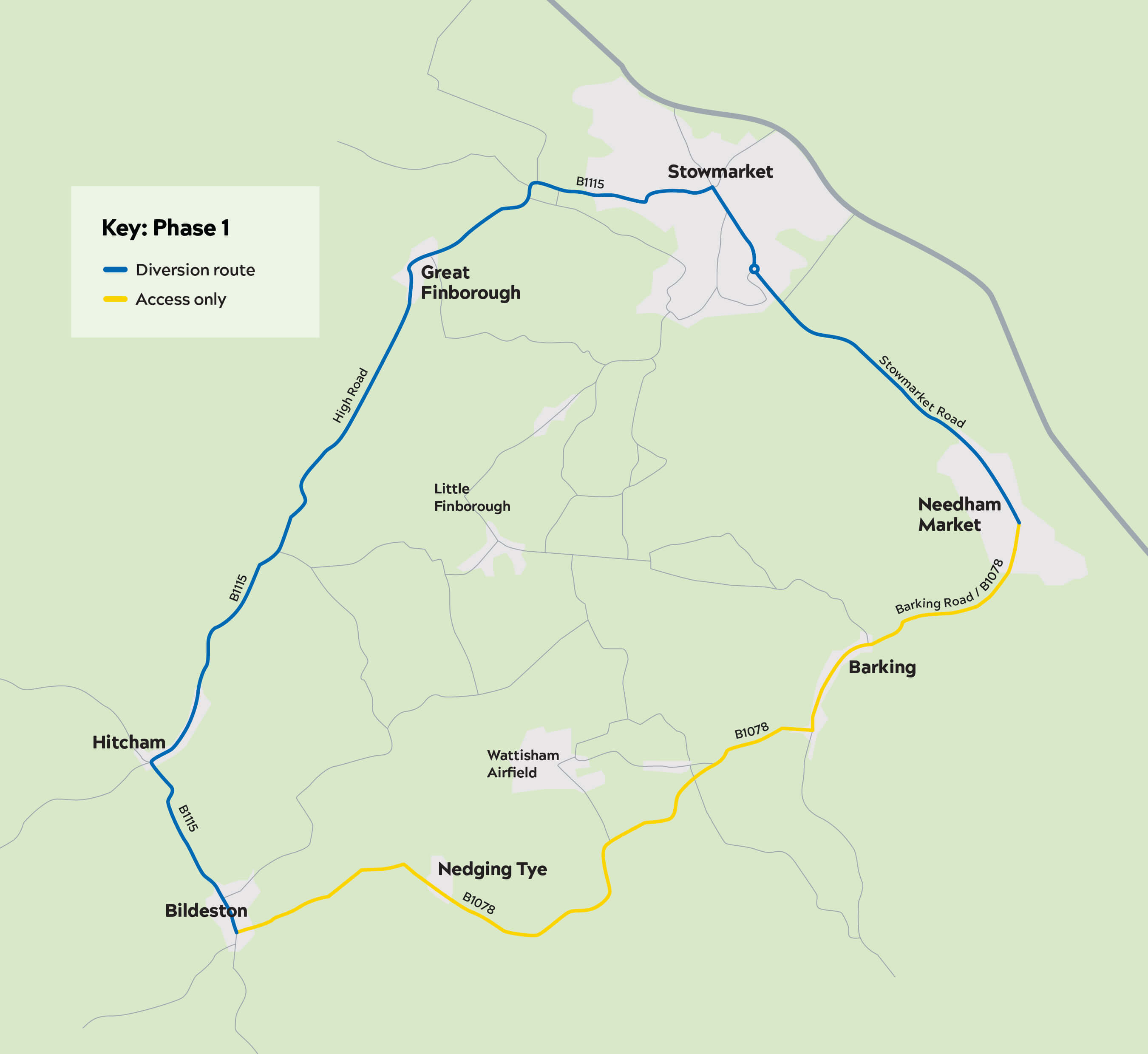

Phase 1 road closure and traffic lights
Ipswich Road and the High Street
22 June
26 June

Phase 2 road closure
High Street from the junction of Ipswich Road to the entrance to the health centre (entrance to remain open)
29 June
17 July

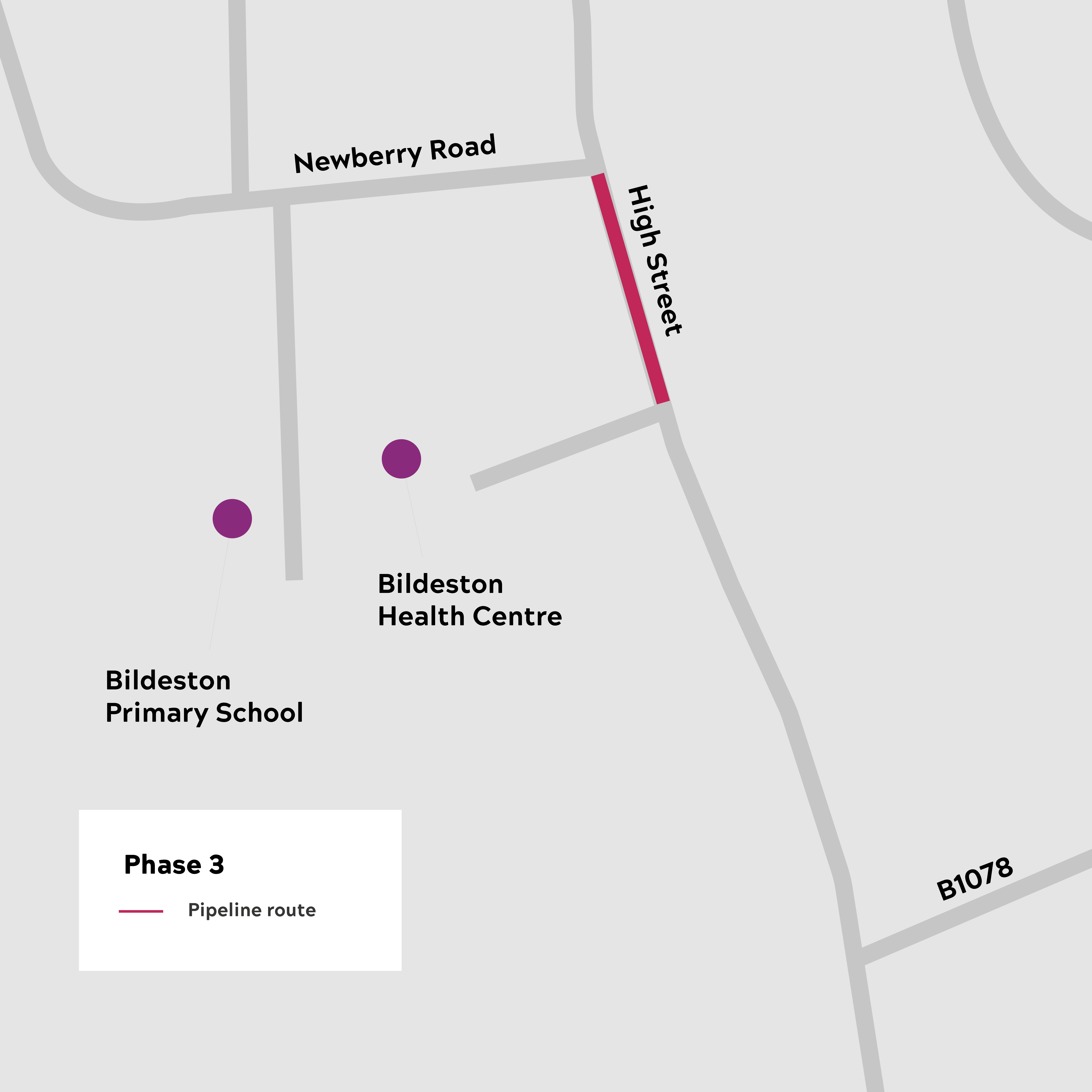

Phase 3 road closure
North of the entrance to the Health Centre to the junction of Newberry Road leaving access into Newberry Road
20 July
31 July
Phase 4a road closure
North of the entrance to Newberry Road to the car park of The Crown
3 August
14 August
Phase 4b road closure
North side of The Crown car park to the junction of Chapel Street
17 August
28 August
Phase 4c road closure
Chapel Street to Duke Street
31 August
4 September

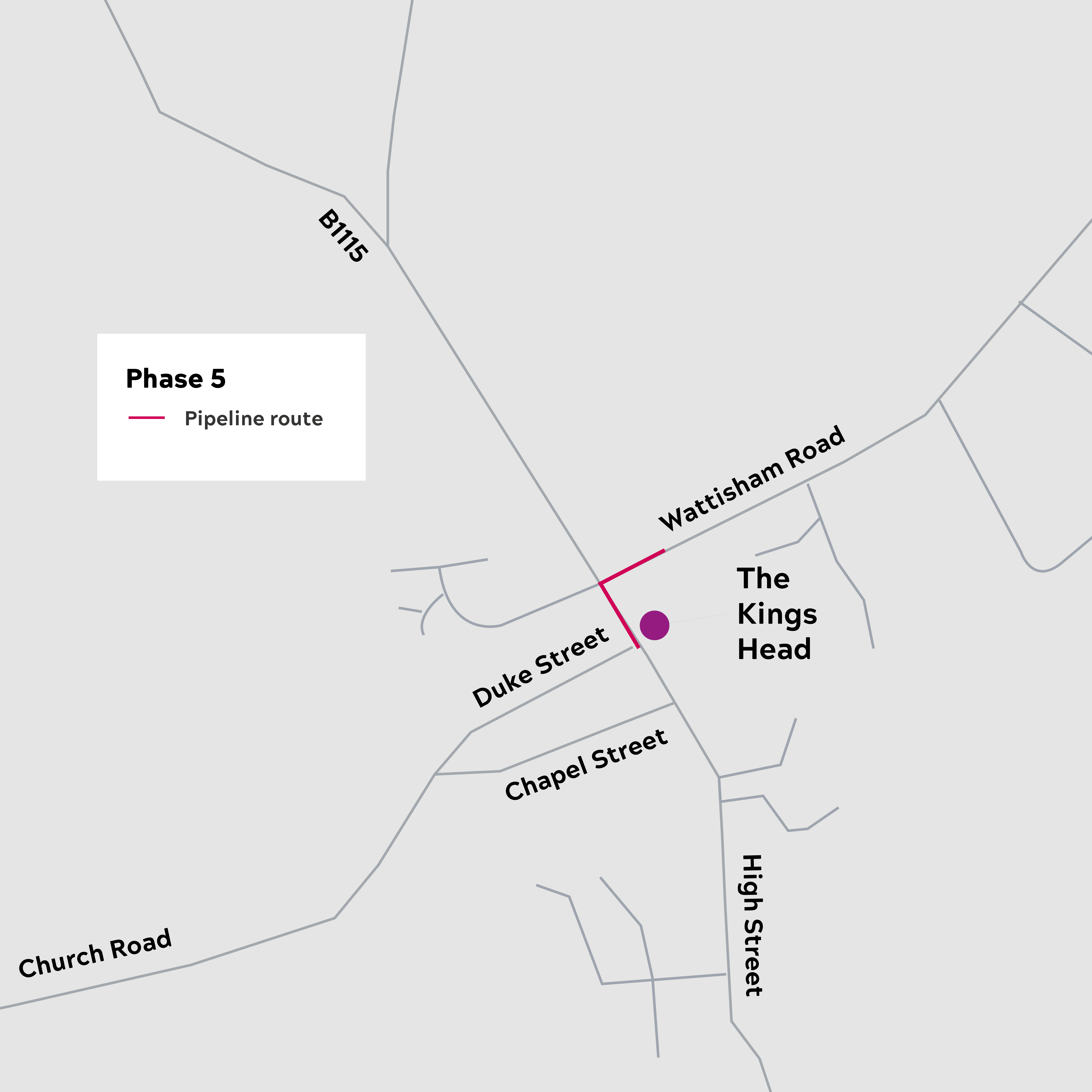

Phase 5 road closure
Duke Street to Wattisham Road
7 September
29 September
Phase 6 road closure
Wattisham Road to the end of the village
30 September
13 November
Phase 7
Bildeston Road to Ipswich Road
TBC early 2027
TBC early 2027
We'll add the maps to the above table soon so you can see exactly where each section is.
Frequently asked questions
The water pipes along High Street have reached the end of their useful life. This has led to over 30 bursts in the past 5 years, which we know has meant low pressure or a loss of supply for some of you. We’re really sorry. That’s why we’re installing brand-new pipes now, to reduce the chances of future bursts and keep your water flowing as it should.
We looked at ways to keep traffic moving, however due to the narrow width of the road this means it wouldn’t be safe and there wouldn’t be enough room to let traffic past while we work.
We’ll share updates through letters, emails, text messages, this page will be updated weekly and via social media.
There will be some construction noise, especially for people who live down High Street. We will do everything we can to keep noise to a minimum and will aim to move any particularly noisy work to later in the day.
We’ll need to dig trenches in the road to lay the new pipes. Once that work is finished, we’ll refill the trenches and repair the road surface with new tarmac. This will be along the sections where we’ve been working, but we won’t be resurfacing the full width of the road.
Yes, the footpaths will stay open for pedestrians. But please take extra care when you're walking past our work.
We’ll try to avoid interruptions where we can. But if we need to switch your water off for a short period at any point, we’ll always let you know in advance.
You can contact us by phone on 03457 919 155 or via email at mlcustomers@anglianwater.co.uk and one of the team will be happy to help.
We will always work with the emergency services and, where it is safe, allow access through the work. If it is not safe at the time, they will need to use the agreed diversion route.
All business will stay open, and we’ll provide access where we can. We’re working with local businesses to understand how our work will impact them and how we can support them throughout. Access will always be available to businesses along the High Street you may just need to take an alternative route to reach them or travel by foot. Please continue to use your local businesses during our work.
We appreciate that following diversion routes can be frustrating and may add extra time or mileage to your journey, and we’re sorry for the disruption this causes. Unfortunately, we’re unable to offer compensation for additional mileage caused by diversion routes. This is the same approach taken by the highways authority.
As we carry out hundreds of essential projects across the region, providing compensation for diversion routes would mean less funding available to invest in maintaining and improving the water network for our customers.
